Accéder au contenu principal
Version : 17.2

Check Out the ADONIS Sample Content

Get Your Inspiration

Explore the content we have prepared to help you discover and get to know the endless possibilities in ADONIS.

Our sample content will give you an introduction into what you can do, as well as where ADONIS can support you. You can access all sample content in your ADONIS model catalogue.

Remarque

The ADONIS sample content is available in all ADONIS:CE and ADONIS Starter Edition accounts, and can also be imported into ADONIS Enterprise Edition accounts if desired.

Step 1Step 2Step 3

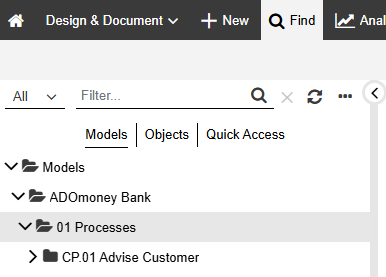

Click FindExpand folderOpen process map
Click on "Find" in the top bar to access your model catalogue.Expand the ADOmoney Bank subfolder "01 Processes".Open the model "Process Map ADOmoney Bank" at the bottom of the directory.

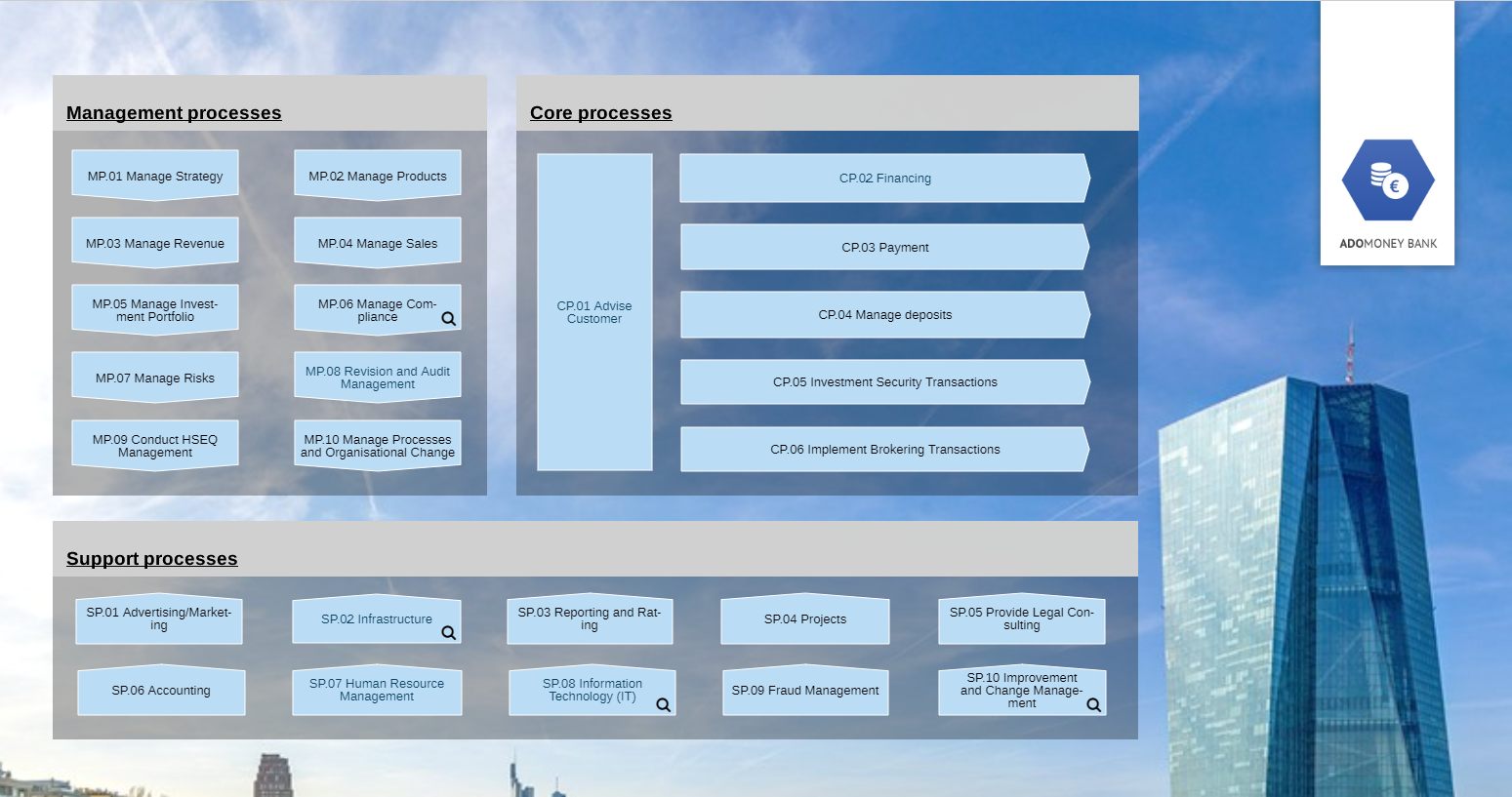

The ADOmoney Bank Process Map

ADOmoney Bank Process Map

The process map provides an overview of all management processes, core processes and support processes of the bank. By clicking on a hyperlink in a process, you drill down to the next level of detail.

Further Levels of the Process Map

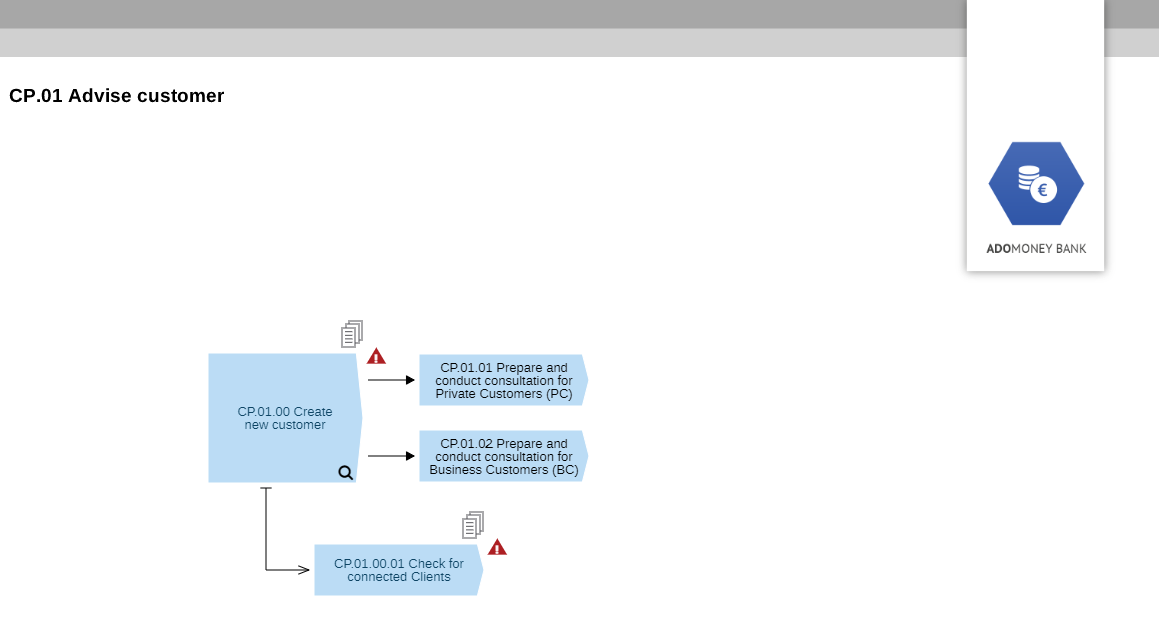

Further Levels of the Process Map

Additional levels of the process map allow a better structuring of the processes. Typically, the second level represents a value-chain, structured by dimensions or determinants, such as product groups and lifecycles.

  1. In the model "Process Map ADOmoney Bank", click the hyperlink in the process "CP.01 Advise customer" to drill-down to the next level of the process landscape.

Alternatively: Search for the model "CP.01 Advise customer" in the model catalogue.

All Details in the Process Model

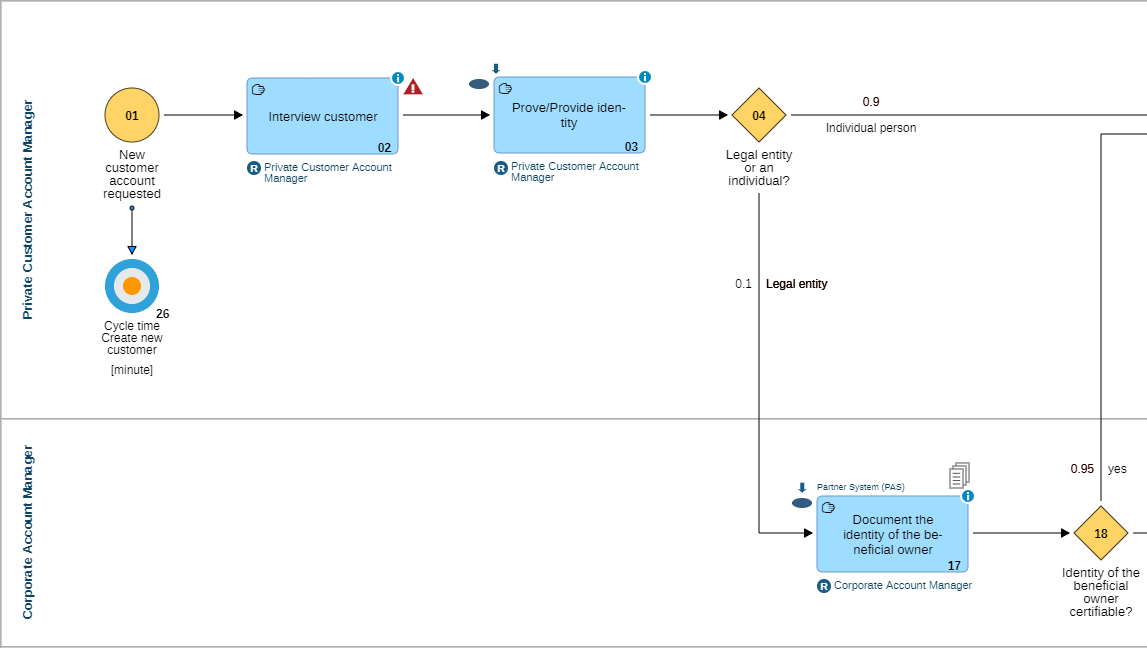

All Details in the Process Model

Drilling down further, the Business Process diagram "CP.01.00 Create new customer" provides a very detailed look at the sequence of tasks and all alternative paths. Furthermore, complementary information, such as RACI, systems used, associated risks and more provide a thorough view on the process.

  1. Click the hyperlink of the process element "CP.01.00 Create new customer" on the second level of the Process Map to drill down.

Go Beyond with BPMN Fit for Business

See how the business initiative "Know Your Customer (KYC)" impacts the "CP.01.00 Create new customer" process and further enterprise assets in your business and IT architecture.

The Business Impact Analysis View

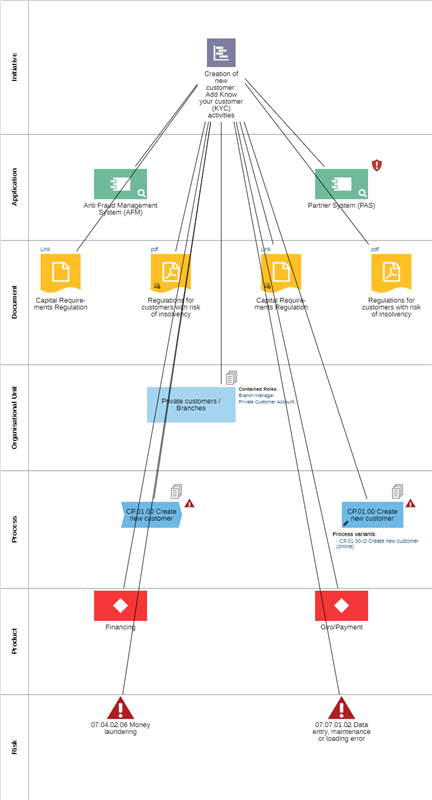

The Business Impact Analysis View

A Business Impact analysis shows the effects of the "Know Your Customer" initiative on the ADOmoney Bank’s corporate artifacts. Affected process: "Create new customer".

  1. Open the object catalogue and enter the term"KYC" in the Explorer search field.
  2. Click with the right mouse button on the initiative "Creation of new customer: Add Know your customer (KYC) activities".
  3. In the context menu, select "Start dependency modeller".
  4. Select the "Initiative Impact Analysis" template, and then click "Create with template".
Remarque

You can remove empty swimlanes in the BIA by selecting them and pressing the key "Del" or via the context menu.

Drill-down to Sequence Flow Level

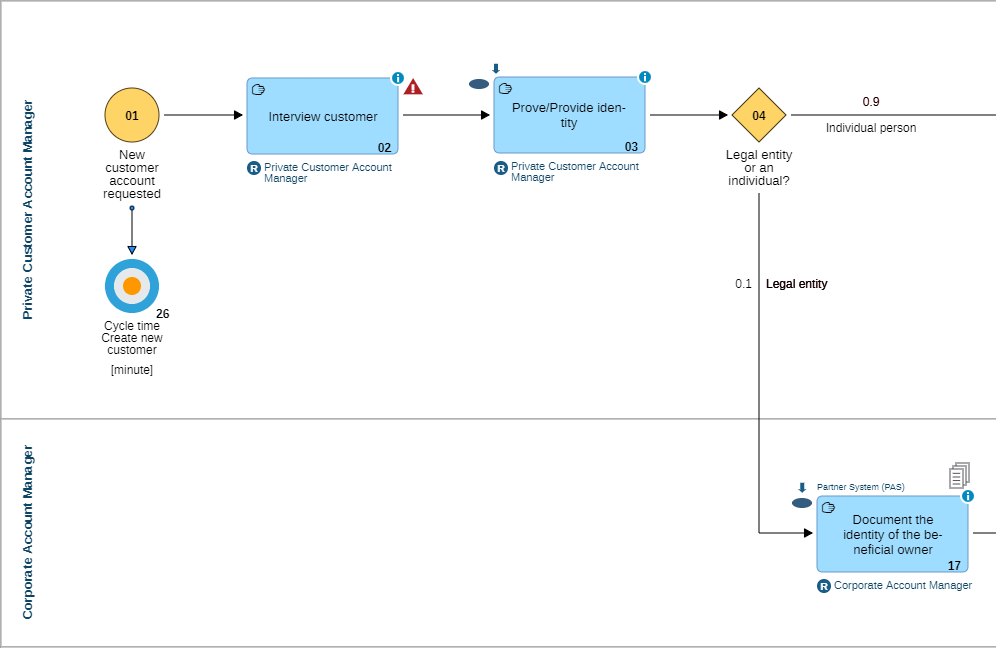

Drill-down to Sequence Flow Level

The process hierarchy can be followed down to the sequence flow level. On that level, the Process Owner can be identified easily.

  1. In the process map "CP.01 Advise customer" click with the left mouse button on the process "CP.01.00 Create new customer" to open the detailed business process diagram.

Detailed Look at Involved Roles via RACI Matrix

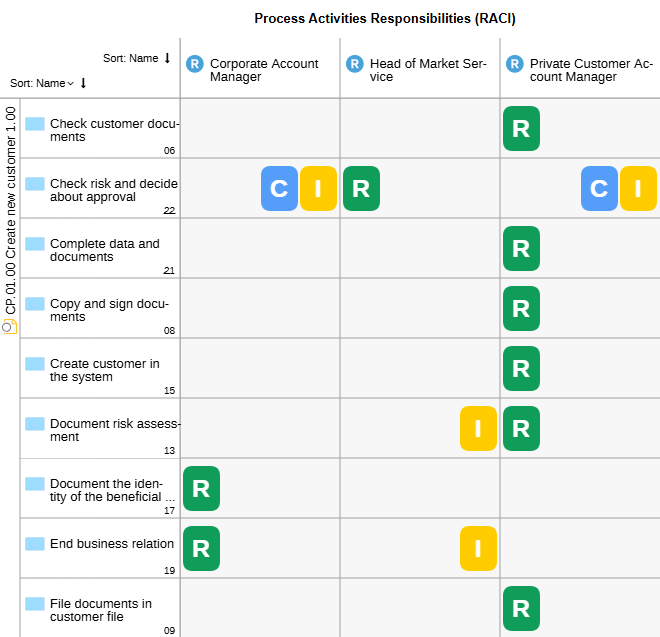

Detailed Look at Involved Roles via Raci Matrix

Another way to show all involved roles in a process and their responsibilities is by creating a RACI matrix.

  1. In the model "CP.01.00 Create new customer" use the context menu "More" with the three dots on the upper right-hand corner of the screen.
  2. Select the option "Create chart" and then "Matrix".
  3. Select the "Process Activities Responsibilities (RACI)" template.

Read the Process Like a Book

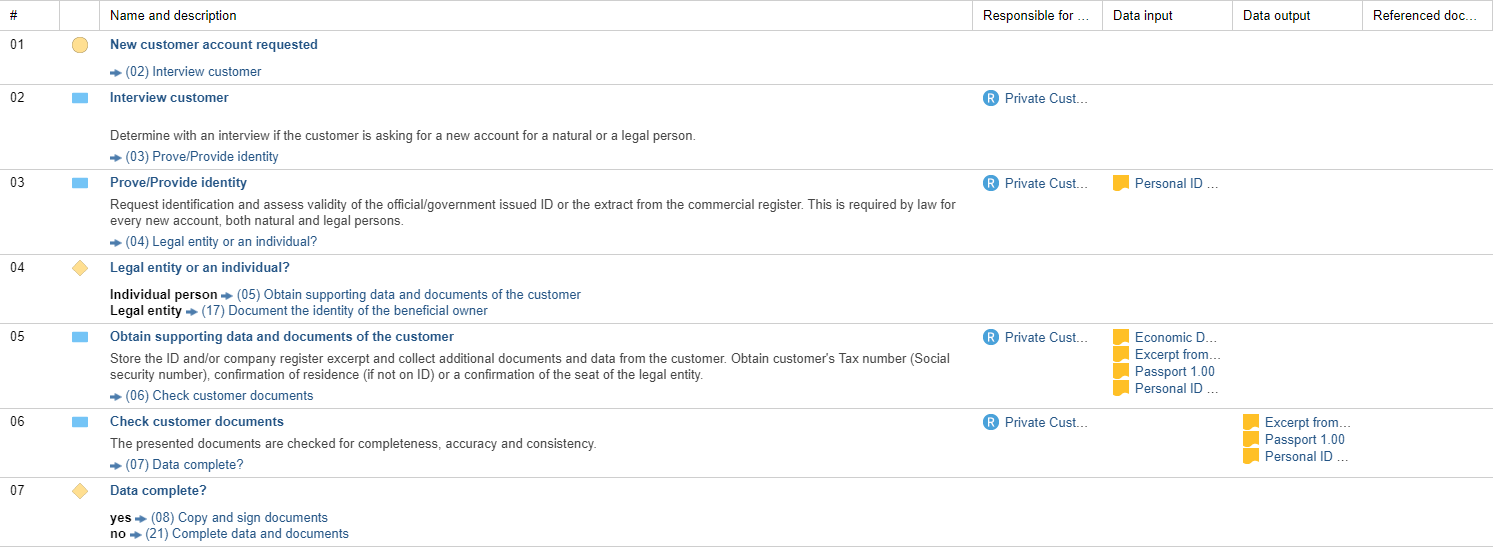

Read the Process Like a Book

The innovative textual view provides a nice alternative to the graphical flow chart. It reads like a book and conveys the descriptions for all Tasks as well as responsibilities and needed resources such as documents and IT applications.

  1. In the model "CP.01.00 Create new customer" change the view in the upper right-hand corner menu from "Model" to "Text".

Analyse the Sequence Flow

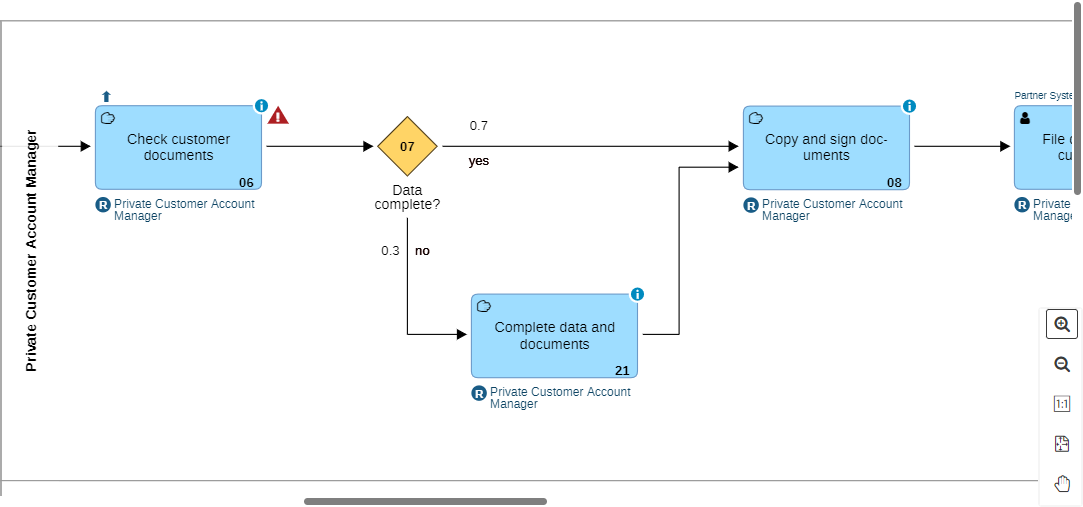

Analyse the Sequence Flow

Before adapting the process as a whole, an overview of the nature of the process can be quickly obtained by taking a look at the sequence flow.

  1. In the model "CP.01.00 Create new customer" change back the view in the upper right-hand corner menu from "Text" to "Model".
  2. Browse through the model and explore it, using the scroll bars or the Zoom tool (located at the lower right corner of the model window).

Adapt the Sequence Flow and Visualize the Change

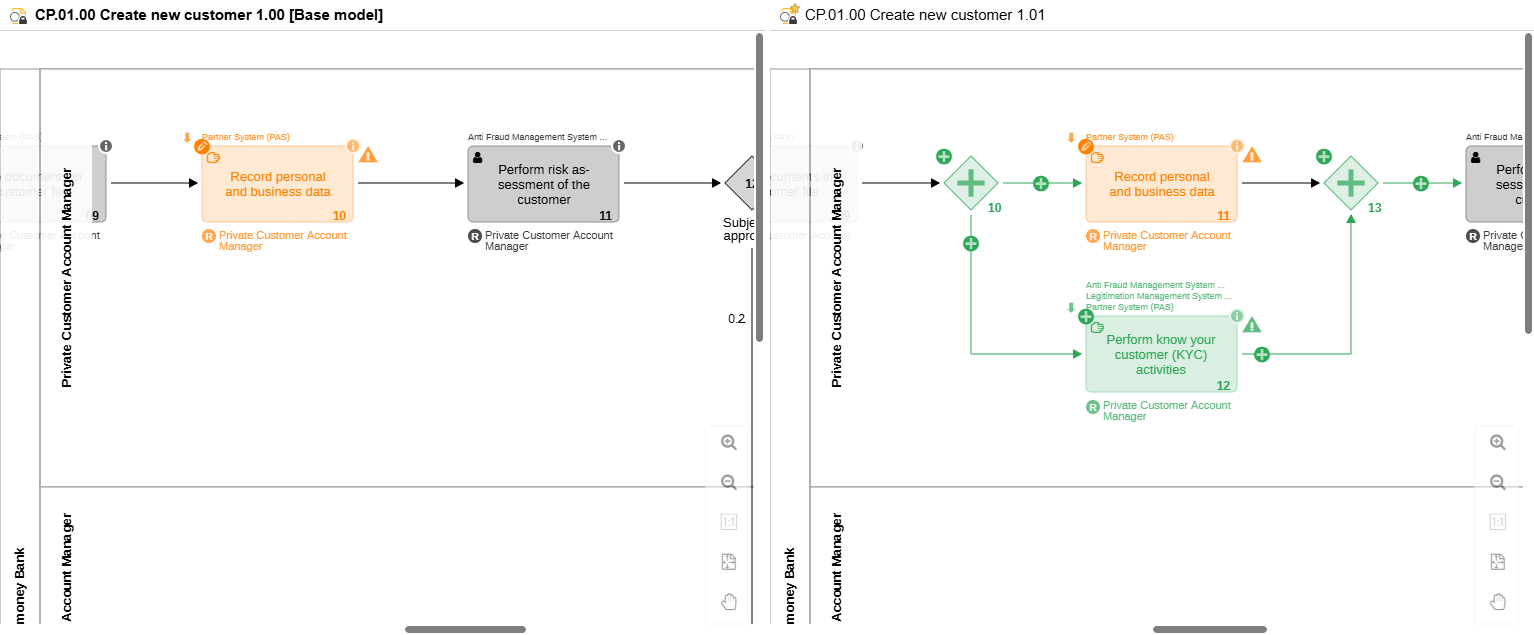

Adapt the Sequence Flow and Visualize the Change

After creating a new version / copy of the model, the "Create new customer" process is expanded according to the "Know Your Customer" initiative. Graphical and tabular model comparison help to highlight this difference.

  1. Open the model catalogue.
  2. Look for the new version "CP.01.00 Create new customer 1.01" and the current version "CP.01.00 Create new customer 1.00".
  3. Select both model versions and use the feature "Compare" from the right-click context menu.

Forward the New Process Version to the Release Workflow

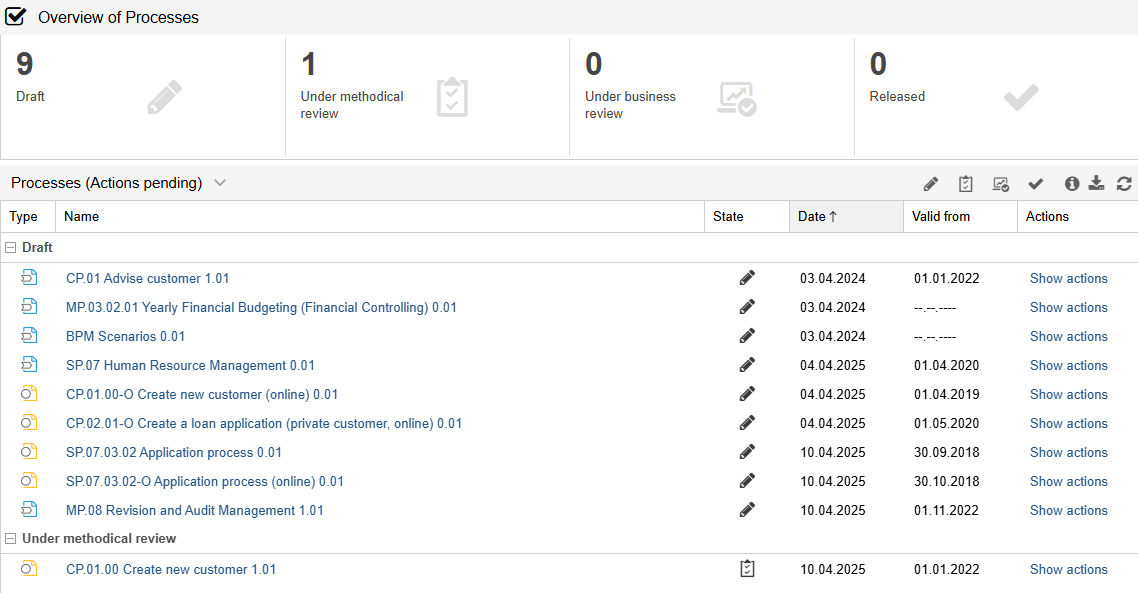

Forward the New Process Version to the Release Workflow

The new version of the "Create new customer" process needs to be reviewed. The Process Release Workflow allows for a governed procedure to be followed, including a complete audit trail.

  1. Switch to the scenario "Control & Release" from the menu bar in the top-left corner of the screen.
  2. Review the model by clicking on it.
  3. Go back to the main view of the scenario "Control & Release".
  4. Click on "Show actions" of the respective model and submit to the next state transition.
  5. As process owner you can release the model after your business review.
Info

This feature is subject to additional licencing.

Monitor the Progress of the Initiative

Monitor the Progress of the Initiative

The progress of the initiative needs to be monitored on an ongoing basis.

  1. On the toolbar at the top of the screen, click "Find".
  2. In the Search box, type "creation of new customer". The search result will include two initiatives that we will look into further: "Creation of new customer: Add Know your customer (KYC) activities" and "Creation of new customer: Examine risk evaluation".
  3. Click the "Create chart" button, and then select "Matrix".
  4. Select the "Initiatives" template.
